Burndown Chart: The Definitive Guide for Agile & Scrum Professionals

Introduction

In today's fast-paced project environments, visibility into team progress isn't just nice to have-it's essential. Whether you're a Scrum Master guiding sprint planning or a Project Manager overseeing multiple initiatives, understanding how work is tracking against expectations can mean the difference between successful delivery and missed deadlines.

In Agile and Scrum environments, burndown charts have become indispensable for visually monitoring project progress.

This guide unpacks everything professionals need to know about burndown charts-from basic definitions to advanced implementation strategies using modern Project Management tools like Teamcamp.

What is a Burndown Chart?

A burndown chart visually tracks the remaining work against the timeline of a project or sprint, helping teams monitor progress and stay on schedule. It "burns down" as work gets completed, creating a visual trajectory of progress that helps teams track whether they're on schedule, ahead, or falling behind.

Explanation: A burndown chart is a visual measurement tool in Agile and Scrum that shows the rate at which work is completed and how much work remains over time, helping teams predict when all work will be finished.

Burn down charts stand out because of their clear and uncomplicated design. With a quick glance, stakeholders can:

  • See how much work remains

  • Compare actual progress against planned progress

  • Identify potential delays early

  • Make data-driven decisions about scope and resources

While simple in concept, effective burn down charts deliver profound insights about team velocity, capacity planning, and project health-making them indispensable for experienced Agile practitioners.

Burn down Chart in Agile and Scrum

In both Agile and Scrum frameworks, burndown charts serve as critical transparency and inspection tools, though with slightly different implementations.

1. Burn down Chart in Agile

In broader Agile methodologies, burndown charts can be applied to:

  • Release planning

  • Feature development tracking

  • Overall project progress

  • Program-level initiative monitoring

Agile teams value burndown charts for their ability to make progress visible to all stakeholders, supporting the Agile principle of "working software as the primary measure of progress."

2. Burn down Chart in Scrum

Within Scrum specifically, burndown charts take on more standardized roles:

  • Sprint burn down charts monitor the work left to finish during an ongoing sprint, which usually lasts between two and four weeks.

  • Product burn down charts provide an overview of how much work remains in the full product backlog.

💡 According to the Scrum Guide, the burndown chart is one of the most effective ways to provide transparency into the work remaining in a sprint, enabling the Development Team to track its own progress and self-organize around meeting sprint goals.

As Mike Cohn, founder of Mountain Goat Software and Scrum Alliance board member, notes: "A burndown chart is the single most effective way to communicate progress and foster a sense of urgency on a project."

Key Elements of a Burndown Chart

Grasping the elements of a burndown chart is essential for accurate analysis and interpretation:

X-Axis (Horizontal)

Represents time, typically measured in days for sprint burndowns or iterations/sprints for product burndowns.

Y-Axis (Vertical)

Represents remaining work, which can be measured in:

  • Story points

  • Tasks

  • Hours of effort

  • Feature count

Ideal Burndown Line

A straight diagonal line from the starting point of total work to zero at the end date, representing perfect, constant progress.

Actual Burndown Line

The jagged line shows real-world progress, which rarely follows the ideal trajectory perfectly.

The gap between the ideal and actual lines tells the most critical story- whether the team is ahead of schedule (actual line below ideal) or behind schedule (actual line above ideal).

How is a Burndown Chart Calculated?

Creating an accurate burndown chart requires careful tracking and calculation. Here's how it works:

Step 1: Establish Total Work

Calculate the sum of all work items (story points, hours, or tasks) at the beginning of the sprint or project.

Step 2: Define Time Period

Determine the duration (sprint length or project timeline) and break it into consistent units (usually days).

Step 3: Calculate the Ideal Burndown

Draw a straight line from the total work amount on day one to zero on the final day. This represents even, consistent progress.

Step 4: Track Actual Remaining Work

At the end of each time unit (day):

  1. Sum the remaining work not yet completed

  2. Plot this point on the chart

  3. Connect to the previous day's point

Step 5: Analyze Patterns

Compare the actual line to the ideal line to assess progress.

Example Calculation:

For a 10-day sprint with 100 story points:

  • Day 1: 100 points remaining (start)

  • Ideal burn down: -10 points per day

  • Day 5:

    • Ideal position: 50 points remaining

    • Actual position (if team completed 40 points): 60 points remaining

In Teamcamp, these calculations happen automatically, allowing teams to focus on the insights rather than the math.

According to the 17th State of Agile Report, 25% of Agile teams are evaluated using the sprint burndown report, underscoring its role in tracking sprint progress.

Sprint Burn Down Chart: Role & Purpose

The sprint burndown chart serves specific functions within the Scrum framework:

Primary Purpose

To provide daily visibility into progress toward the sprint goal, enabling the team to:

  • Identify impediments early

  • Adjust daily work plans

  • Forecast whether the sprint goal is achievable

Key Benefits of Sprint Burndown Charts

  1. Transparency: Everyone sees the same progress data

  2. Early warning system: Identifies potential issues before they become critical

  3. Self-management tool: Helps teams regulate their own pace

  4. Motivation: Creates a visual incentive to stay on track

When to Use Sprint Burndown Charts

  • During daily stand-ups, focus groups are held

  • In sprint reviews, to explain progress patterns

  • For sprint retrospectives to identify improvement opportunities

  • With stakeholders to set expectations about delivery

One Teamcamp user, a Scrum Master at a financial technology company, reports: "Our sprint burndown charts have transformed our daily stand-ups. Instead of status reporting, we now focus on addressing impediments visible in the chart's trajectory."

Burn down Chart Example: A Visual Guide

Let's examine a realistic burndown chart scenario to understand how it reflects team progress.

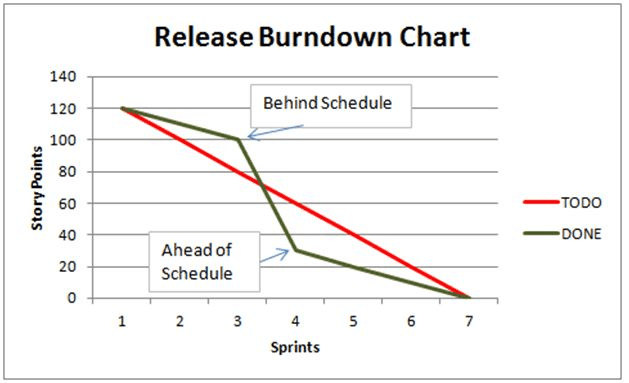

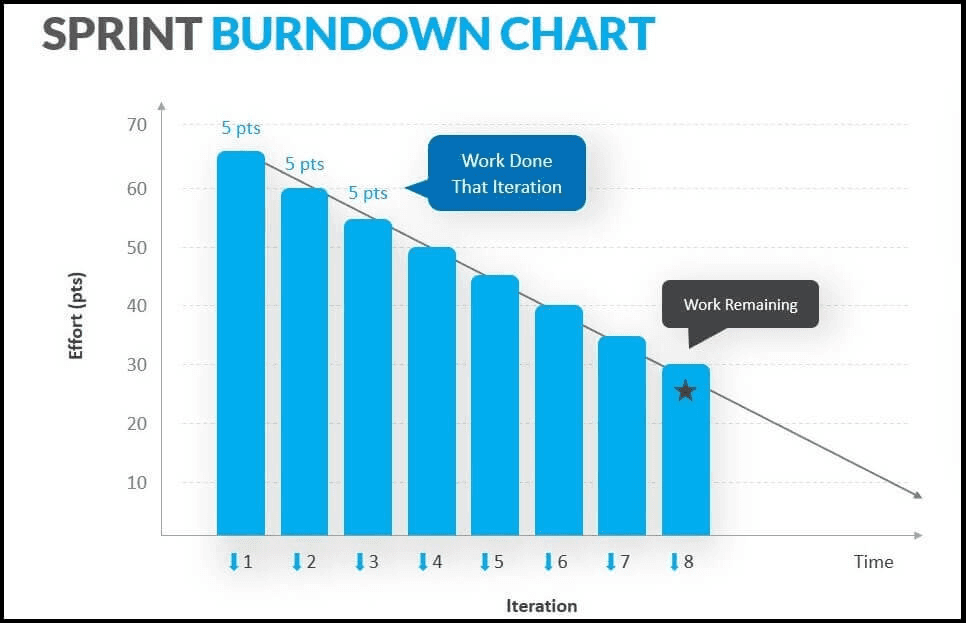

Sample sprint burndown chart from Teamcamp showing common patterns

In this example from Teamcamp, we can observe several typical patterns:

  1. Initial flat line: The first two days show little progress as the team ramps up

  2. Mid-sprint acceleration: Days 3-7 show steeper decline as team hits peak productivity

  3. Weekend plateau: No change over the weekend (days 8-9)

  4. Final push: Steeper decline in the final days as team focuses on completion

Interpreting This Chart

This team started slower than ideal but made significant progress mid-sprint. The final trajectory suggests they'll complete all committed work by the sprint end-a successful outcome.

Common Burndown Chart Mistakes and How to Avoid Them

Though simple in design, Burndown charts often fall victim to misuse, which can distort project tracking and team performance insights. When these charts do not reflect reality, decisions based on them can be flawed.

Here , are frequent pitfalls teams encounter when using burndown charts, along with practical ways to prevent them:-

Inconsistent updates:

  • Teams sometimes skip daily updates, leading to charts that lag behind progress.

  • Solution: Include burndown chart updates as a regular task during daily stand-ups or sprint check-ins. Automate updates through integrated project management tools like Teamcamp to reduce manual effort.

Misestimated story points:

  • Poor estimation inflates or deflates the chart, confusing actual velocity.

  • Solution: Involve the entire team in estimation. Rely on past sprint data and team estimation techniques like planning poker to gradually improve accuracy.

Ignoring external blockers:

  • Teams often fail to document or visualize delays caused by external dependencies (e.g., waiting on a third-party API).

  • Solution: Track blockers separately and annotate the burndown chart when such events occur. Tools that support customizable workflows help surface these issues transparently.

Avoiding these common mistakes ensures your burndown chart remains a reliable reflection of progress.

Burndown Chart vs. Burnup Chart in Agile

Understanding the difference between burndown and burnup charts helps teams choose the correct visualisation for their needs:

Burndown Chart

  • Shows: Work remaining over time

  • Direction: Trends downward as work is completed

  • Best for: Sprint tracking, straightforward projects with fixed scope

  • Advantage: Simple to understand; creates urgency

Burnup Chart

  • Shows: Work completed AND total scope over time

  • Direction: Trends upward as work is completed

  • Best for: Projects with changing scope, release planning

  • Advantage: Visualizes scope changes; shows total achievement

Feature

Burndown Chart

Burnup Chart

Visualizes remaining work

Visualizes completed work

Shows scope changes

Simplicity

Higher

Moderate

Best for tracking

Fixed-scope sprints

Dynamic projects

Many experienced teams use both chart types complementarily: burndown for sprint-level tracking and burnup for release or product-level monitoring.

Best Practices for Using Burndown Charts

To maximize the value of burndown charts, follow these expert recommendations:

Do's

  1. Update daily: Ensure the chart reflects the most current reality

  2. Discuss as a team: Use the chart to facilitate conversations about progress

  3. Look for patterns: Analyze repeated trends across multiple sprints

  4. Keep it visible: Display the chart where the team can see it constantly

  5. Right-size your work: Break down items small enough to show regular progress

Don'ts

  1. Don't use it punitively: The chart is a tool for improvement, not punishment

  2. Don't manipulate estimates: Changing estimates to make the chart look better undermines its value

  3. Don't ignore context: Understand the story behind the numbers

  4. Don't overreact to daily fluctuations: Look for trends, not daily blips

  5. Don't track individual performance: Burndown charts are team tools, not individual metrics

Real-World Example

A Teamcamp customer in the healthcare software industry shares: "We noticed our burndown charts consistently showed a 'hockey stick' pattern-flat progress followed by a steep drop at the end. By analyzing this pattern in our retrospectives, we identified that our user stories were too large. After breaking them down further, our burndown became more gradual and predictable, and our delivery became more reliable."

Burn down Chart FAQs

1. What is a burndown chart and what does it represent?

A burndown chart is a visual project management tool used in Agile and Scrum to track the amount of work remaining in a sprint or project over time. It represents the relationship between the work left (like story points or tasks) and the time available, showing whether a team is on pace to complete their objectives.

2. How is a burndown chart calculated?

A burndown chart is calculated by recording the total remaining work at the end of each day during a sprint or project. This value is plotted on a graph, creating an actual progress line that is compared to the ideal line from the start to the projected finish.

3. What is the purpose of a sprint burndown chart in Scrum?

In Scrum, the sprint burndown chart visually tracks progress toward completing all sprint backlog items. Its main purpose is to help teams and stakeholders quickly identify whether the sprint goal is achievable, spot bottlenecks early, and make informed daily decisions.

4. How do I create a burndown chart in Teamcamp (or other project management tools)?

To create a burndown chart in Teamcamp, select your sprint or project, ensure all tasks are estimated, and use the automated reports dashboard to visualize daily progress. Teamcamp updates the chart in real time, offering easy tracking and export options. Other tools like Jira follow a similar process within their Scrum board reports.

5. What’s the difference between a burndown chart and a burnup chart in Agile?

A burndown chart shows the amount of work left to complete, trending downward over time. A burnup chart, in contrast, displays work completed versus total scope, trending upward and clearly visualizing scope changes. Both are valuable but serve different tracking needs in Agile projects.

These FAQs directly address what Agile and Scrum professionals are searching for and position your content as both authoritative and user-focused.

Conclusion

The burndown chart stands as one of the most powerful yet straightforward tools in the Agile and Scrum professional's toolkit. Its visual simplicity belies its profound impact on project transparency, team accountability, and delivery predictability.

When implemented correctly-with consistent updates, thoughtful analysis, and team engagement burndown charts transform abstract project metrics into actionable insights that drive successful delivery.

Ready to elevate your project tracking? Try Teamcamp today — the all-in-one project management tool designed to streamline your workflow and help you manage burndown charts with ease.

References & Further Reading

Teamcamp Project Management Blogs

Ultimate Project Management Guide

Steps to Successfully Take Over a Project

Author Details

Naik Pratham is a content writer and project manager specializing in product development and tech workflows. With experience leading software projects and creating educational content, Pratham combines practical knowledge with clear communication to help teams maximize their tools and processes. Follow his insights at dev.to/pratham_naik_project_manager.

Share :

Unlock Seamless Collaboration

Bring your team together with Teamcamp’s intuitive tools.

Unlock Seamless Collaboration

Bring your team together with Teamcamp’s intuitive tools.

Unlock Seamless Collaboration

Bring your team together with Teamcamp’s intuitive tools.

Unlock Seamless Collaboration

Bring your team together with Teamcamp’s intuitive tools.

Product

Solution

Resources

Company

Guide

© 2025 Teamcamp
